How to set up automated planning cycles
Overview
The Cycle schedule setting allows you to automate the creation and management of Budget and Forecast planning cycles. You can define when planning cycles open, how long users can submit their plans, how long reviewers have to approve them, and how generated plan versions are named.
Once configured, PMI automatically creates future plan versions according to your schedule, helping ensure a consistent and repeatable planning process.
Objective
By the end of this task, you will have configured the automated rules that control when your Budget and Forecast plan versions open each cycle, how long your team has to submit their numbers, how long you have to review, and what every generated version is named — so the system runs each planning round automatically from this point forward.
Before you begin
This functionality is not automatically available for all chains. If you want it activated, contact support@d2o.com.
Who can do this?
- System administrator
- Hotel controller / Finance manager
When can this be configured?
You can set up or change Cycle schedule settings at any time. If a plan version is currently Open (your team is actively working on it), the system will ask you how the changes should be applied before saving — it will not block you or apply changes silently.
How Cycle Schedule Works
Cycle Schedule automates the creation of Budget and Forecast planning cycles based on rules that you define.
The setup process consists of three stages:
- Configure Budget and/or Forecast planning cycle rules.
- Define how generated plan versions should be named.
- Review and activate the generated schedule.
Before configuring these rules, you must first open the Cycle Schedule configuration page.
Open the configuration
Go to Profit & loss > Settings > Cycle schedule, then select your collection from the list.
The setup wizard opens on the first step: Planning cycle scope.

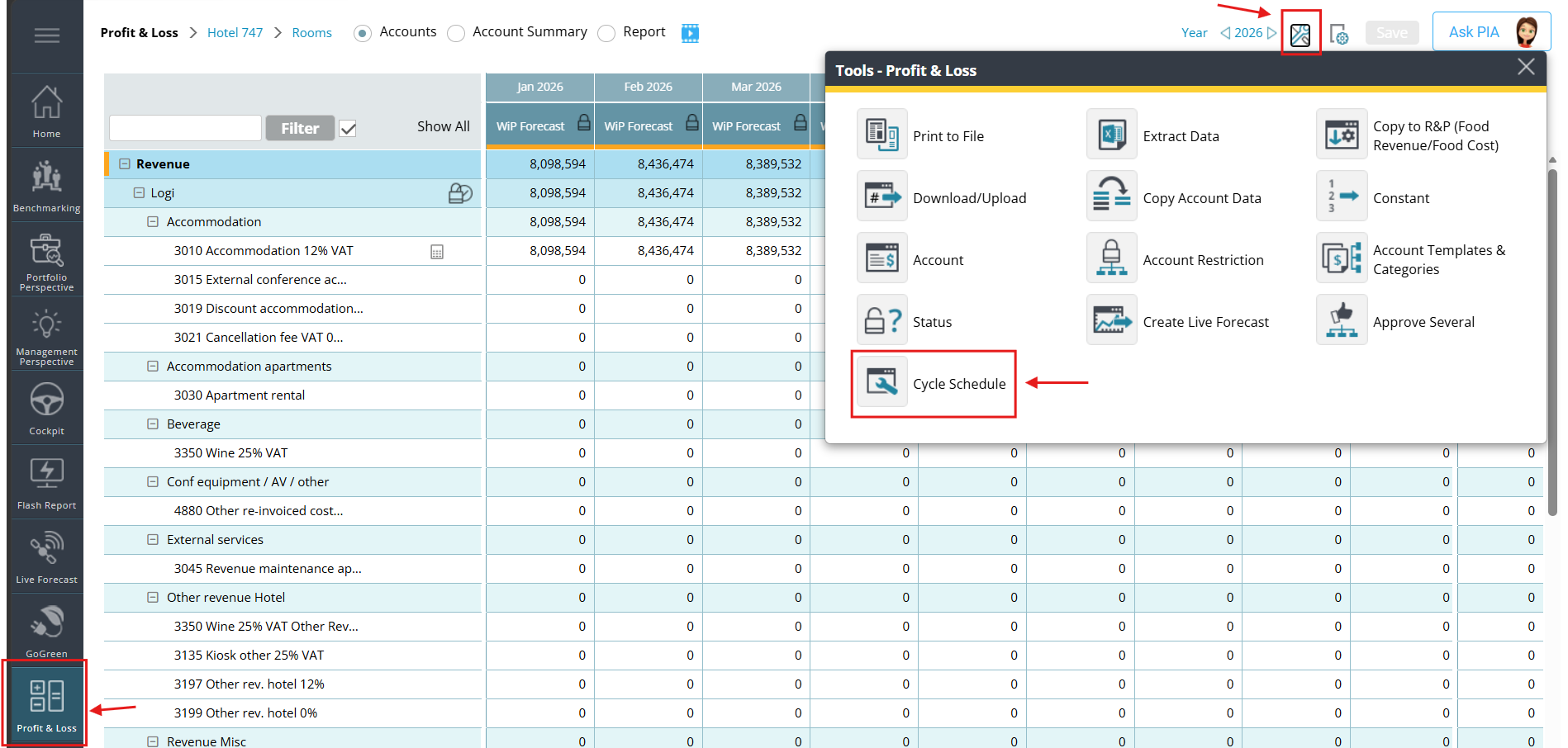

Image description: Navigation to the Cycle schedule
Step 1: Configure planning cycle rules
In the Planning cycle scope stage, configure the rules for your budget and forecast planning cycles.
1.1 Configure budget cycles (skip if you’re not running a budget)
Check the Budgeting checkbox at the top of the budgeting card.
When enabled, the budget cycle settings become available. If disabled, the fields collapse and the Budget cycle is disabled.

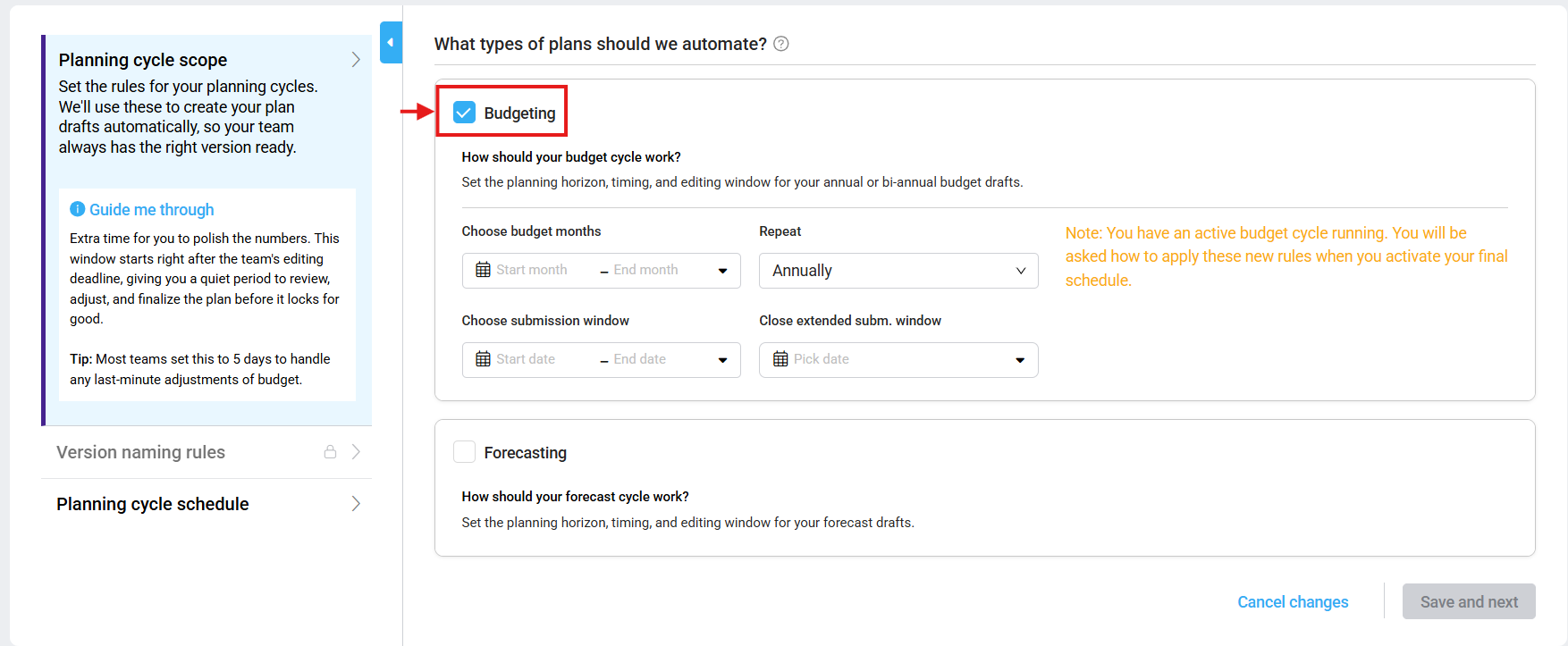

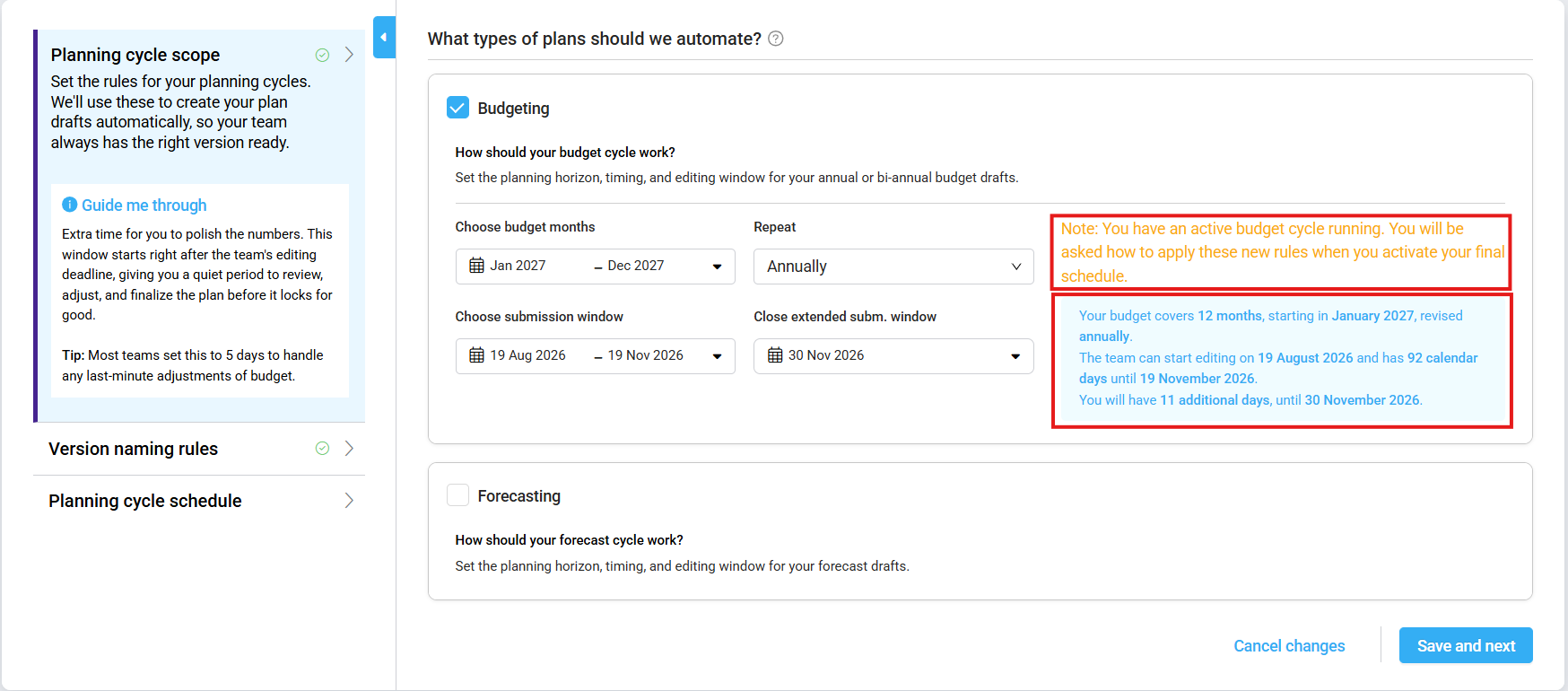

Image description: Configuring your budget
Complete the budget cycle settings.
Configure the following fields:
Review the summary panel
As you complete the fields, the summary panel displays the calculated planning cycle details, including the planning period, submission window, and review period.
Review these details before continuing. If the dates or timings are not correct, adjust the settings accordingly.
If an orange warning is displayed, an active budget cycle already exists. You can continue configuring the settings and decide how changes should be applied when saving.

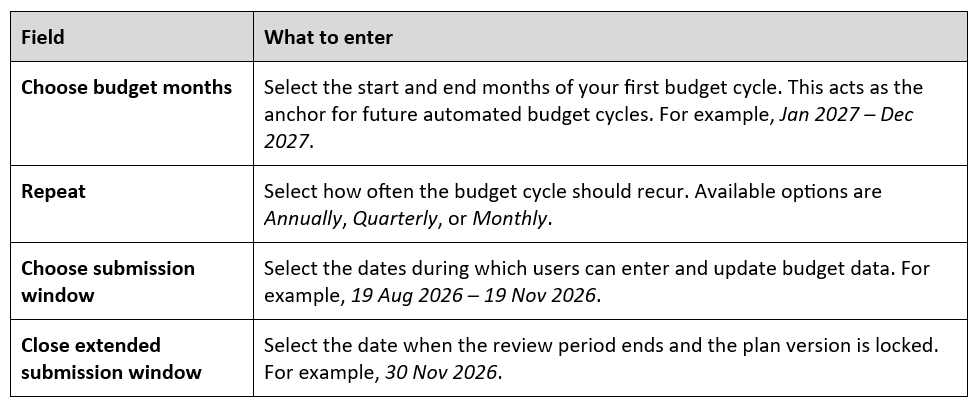

Image description: Budget summary and warning
1.2 Configure forecast cycles (skip if you’re not running a forecast)
Enable Forecasting and configure the planning cycle settings for your forecast process.
The same fields are available as for budgeting:
- Choose forecast months – Select the start and end months of your first forecast cycle.
- Repeat – Select how often the forecast cycle should recur.
- Choose submission window – Select the dates during which users can enter and update forecast data.
- Close extended submission window – Select the date when the review period ends and the forecast version is locked.
Budget and forecast cycles are configured independently and can use different schedules, submission windows, and review periods.
Note: At least one plan type must remain enabled. If both budgeting and forecasting are disabled, the schedule cannot be saved.
Step 2: Configure version naming rules
Version naming rules help ensure generated plan versions are easy to identify and remain consistent across properties and planning cycles.
Select Save and next to open the Version naming rules step.

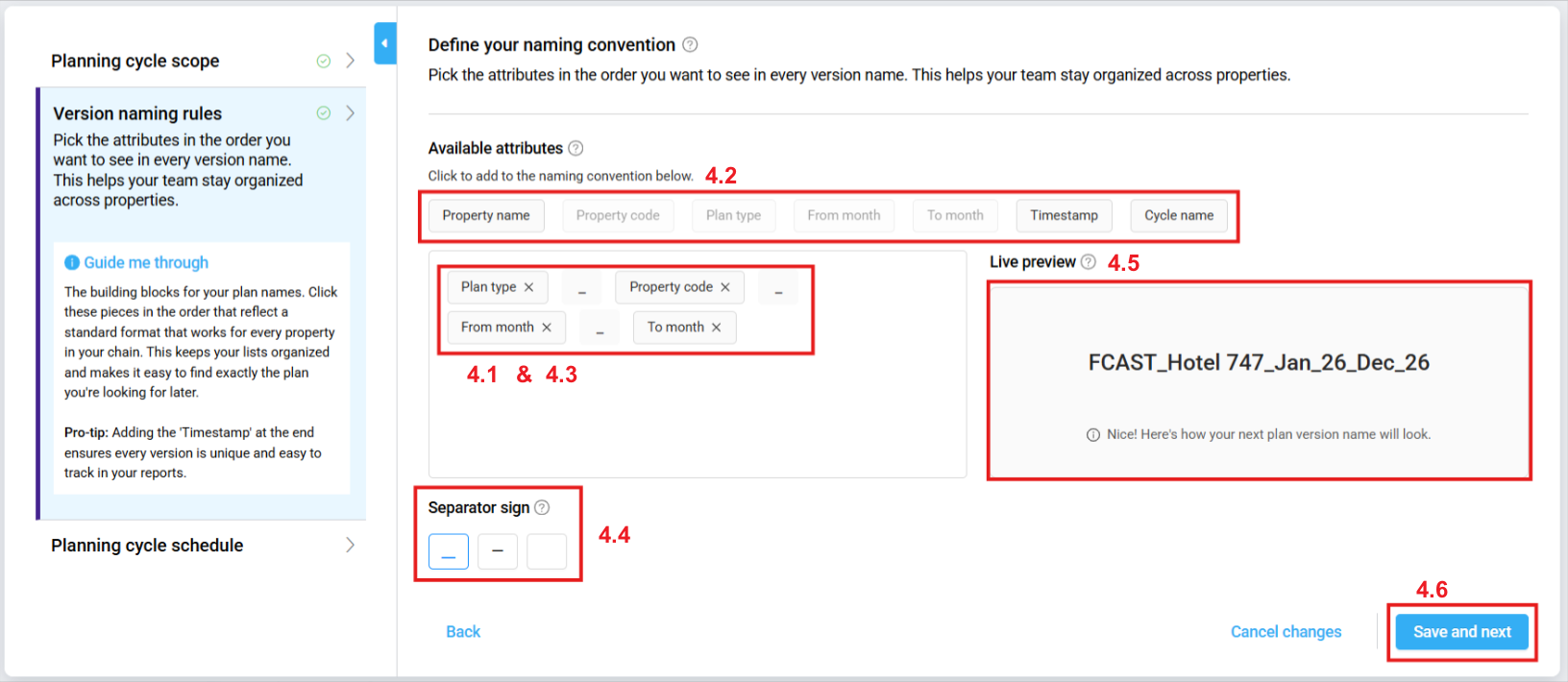

Image description: Version naming rules settings
4.1 Review the default format
The builder area is pre-filled with: [Plan type] _ [Property code] _ [From month] _ [To month]. This is the system default. You can keep it or customise it.
4.2 Add more name pieces (optional)
The Available attributes panel shows additional building blocks you can add: Property name, Cycle name, Timestamp. Click any chip to add it to the builder. Once a chip is in the builder, it greys out in the available list — it can’t be used twice.
4.3 Reorder or remove pieces (optional)
- Drag chips within the builder area to change their order.
- Click the × on any chip to remove it from the name.
Required: The builder must always contain either Property name or Property code. Remove both and the Save and next button disables with an inline warning.
4.4 Choose a separator
Under Separator sign, pick one of three options: underscore ( _ ), dash ( — ), or space.
4.5 Check the live preview
The Live preview panel on the right shows exactly how your next generated version name will look. Check it carefully. Once the schedule is live, this naming format applies to every future version.
Note: Renaming past versions is not possible.
4.6 Click Save and next.
Step 3: Review the planning schedule

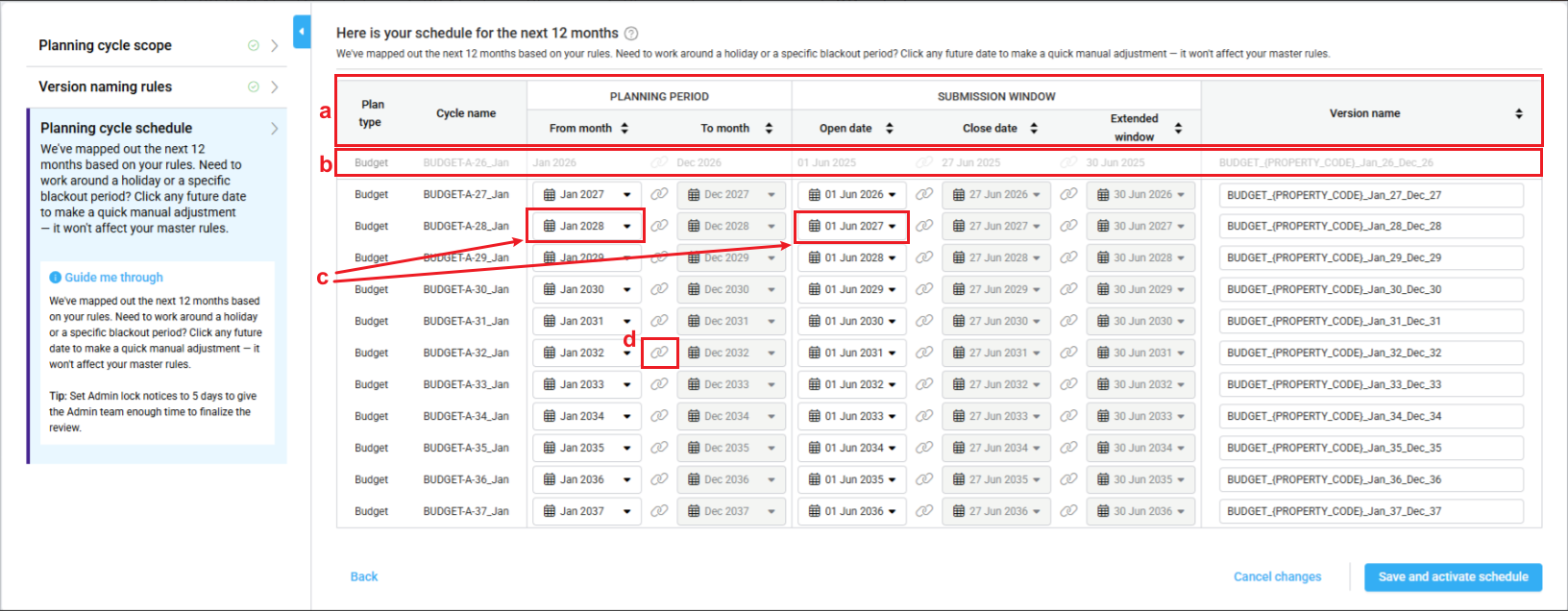

The planning cycle schedule displays all generated budget and forecast cycles for the next 12 cycles.
Use this view to verify that the schedule created from your rules matches your planning requirements.
Image description: Adjusting individual cycle schedule
3.1 Read the schedule table
The table maps out every planned Budget and Forecast cycle for the next 12 months, with columns for Plan type, Cycle name, From month, To month, Open date, Close date, Extended window, and Version name. (a)
Greyed-out rows at the top are past (Locked) cycles — they are read-only and cannot be changed. (b)
3.2 Adjust individual cycles (optional)
For any future or currently Open row, click a date cell to open a date picker and shift that specific cycle’s date. This changes only that one cycle — your master rules for all other cycles stay exactly as you set them. (c)
To move two linked dates together (for example, shifting both the open and close date forward as a block), keep the chain link icon between them in linked mode. To edit just one date on its own, click the chain icon first to unlink the pair. (d)
Step 4: Save and activate
Select Save and activate schedule.
If any active planning cycles are affected by your changes, PMI will display a confirmation message before saving.

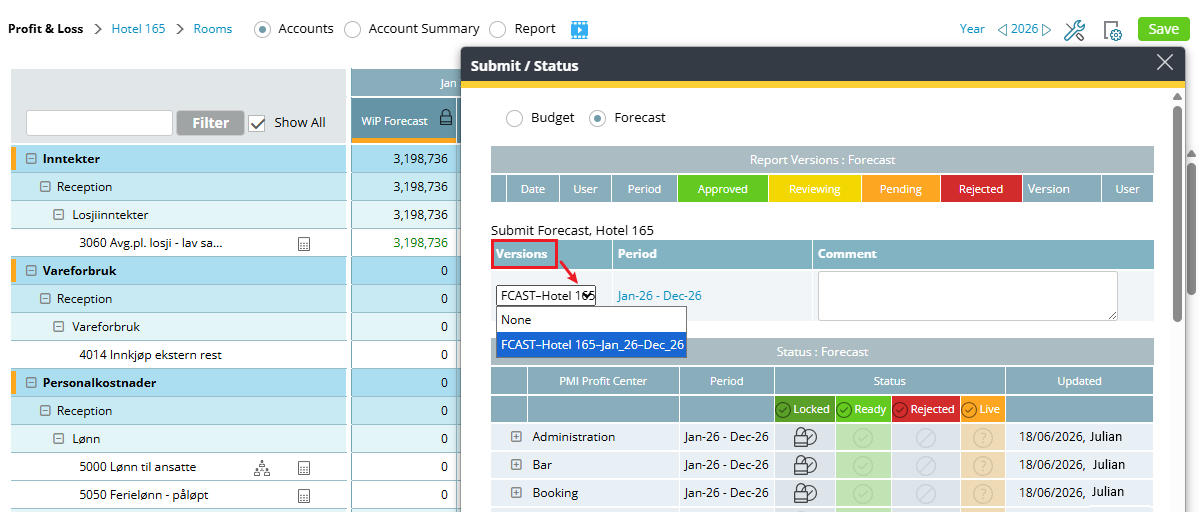

Image description: Example of the version name in P&L Status
Handling confirmation prompts
Depending on the changes you make, PMI may display one of three confirmation prompts before saving your schedule. These prompts help you decide how changes should be applied when active planning cycles are already in progress.
Prompt A — “You have an active planning cycle”
This appears when you changed a master rule and there is currently an open Budget or Forecast cycle of that same type.

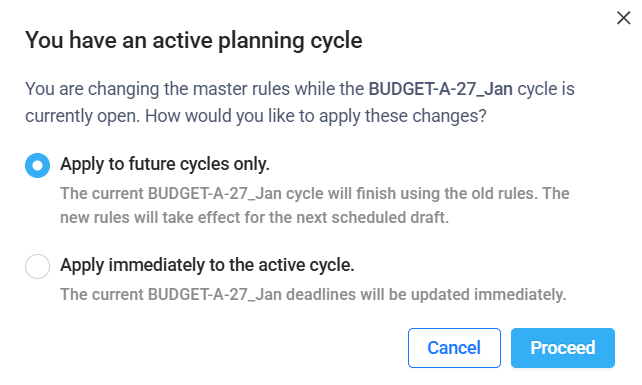

Image description: Confirmation popup during an open budget/forecast cycle
- Apply to future cycles only (selected by default) — Your team finishes the current cycle under the old deadline. The new rules kick in from the next cycle onward.
- Apply immediately to the active cycle — The current cycle’s deadlines update right now.
Click Proceed, or Cancel to go back.
Prompt B — “You are modifying an active cycle”
This appears when you directly edited a date on an open cycle row in the schedule table (Step 3.2).
It confirms that your manual change overrides the master rule for that one cycle only.
All other cycles stay on master rules. Click Confirm & update, or Cancel to undo.

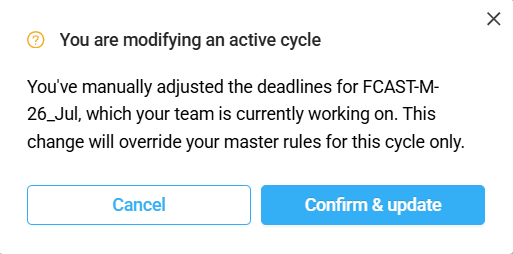

Image description: Confirmation when date is modified during an active cycle
Prompt C — “Confirm schedule updates”
This appears when you both changed a master rule AND directly edited an open cycle row for the same plan type.
Your direct edit wins: the active cycle uses your manual dates, and the new master rules apply to all future cycles.
Click Confirm & update, or Cancel.
Best practices
- Give yourself a realistic review period by allowing sufficient time between the submission deadline and the extended review deadline.
- Use direct schedule edits for one-off exceptions rather than changing your master rules.
- Use a consistent version naming convention across all properties to simplify reporting and plan management.
Related articles
Plan version automation – Never miss budget season again
How the system calculates your planning schedule
-
Getting started
-
-
- Arrivals/Departures
- Data elements required from PMS
- Manual Export PMS – Fidelio
- How to do a manual PMS export from Opera
- Manual Export PMS – Picasso
- Manual Export PMS – Protel
- Manual Export PMS – Spirit Web
- PMS – Cenium
- PMS – Citybreak
- PMS – Fidelio
- PMS – Opera
- PMS – Protel
- How to do a manual PMS export from HotSoft
- PMS – Skidata
- How to set up an Opera reports export
- PMI API
- PMI API Best Practice Get Forecasted hours
- PMI File Agent setup and documentation
- Technical specification for data integration
- How to transfer data to PMI
- How to enable Opera Cloud reports
- PMI system integration overview
- Opera Scheduler setup - Reservation Statistics 1
- Opera Scheduler setup - Report Trial Balance (trial_balance)
- Opera Scheduler setup - Reservation Forecast, (res_forecast)
- Opera Scheduler setup - Reservation History & Forecast (history_forecast)
- Opera Scheduler setup - Daily Forecast Report
- Opera Scheduler setup - SFTP transfer guide
- Manual Export PMS Opera
- Report 1 (manual export): Reservation Statistics 1 (res_statistics1)
- Report 2 (manual export): Reservation Forecast, (res_forecast)
- Report 3 (manual export): Trial Balance (trial_balance)
- Report 4 (manual export): Reservation History & Forecast (history_forecast)
- Show all articles ( 4 ) Collapse Articles
-
- Understanding Productivity in Hospitality (and Why It Matters in PMI)
- How Forecasting Drives Productivity in Hotels
- The Most Important Productivity KPIs in Hospitality
- The Hotel Productivity Management Cycle
- Hospitality Productivity and PMI – Quick overview
- Balancing Productivity, Cost Control, and Guest Service in Hotels
-
Video tutorials
-
- Administration Labor cockpit [14:49]
- Bar and Pub Labor cockpit [12:21]
- Breakfast Labor cockpit [12:05]
- Consolidated view in Benchmarking and Management Perspective [3:20]
- Flash Report Onboarding [6:27]
- Flash report overview [2:25]
- Food cost cockpit [6:21]
- Kitchen Labor cockpit [11:28]
- Labor Cockpit Onboarding [18:16]
- Labor cockpit overview [3:12]
- Live forecast 1/5 navigation [5:05]
- Live Forecast 2/5 Rooms [5:05]
- Live forecast 3/5 meeting & event [5:40]
- Live forecast 4/5 food & beverage [6:11]
- Live forecast 5/5 breakfast [7:19]
- Live forecast onboarding [6:06]
- Live forecast overview [2:58]
- Management perspective overview [3:06]
- P&L Planning 1/10 Purpose and benefits [2:25]
- P&L Planning 10/10 How to approve forecast and budget or target [2:34]
- P&L Planning 2/10 Navigation [4:26]
- P&L Planning 3/10 How to build a total [4:29]
- P&L Planning 4/10 Three ways of inserting figures [4:32]
- P&L Planning 5/10 How to add a sub account [1:42]
- P&L Planning 6/10 How to build a constant [2:42]
- P&L Planning 7/10 Staff module [2:48]
- P&L Planning 8/10 How to add a staff member [1:33]
- P&L Planning 9/10 How to revise and submit a forecast [3:01]
- Repair and Maintenance Labor cockpit [13:01]
- Restaurant Labor cockpit [12:30]
- Schedule 1/8 Navigation [5:12]
- Schedule 2/8 How to create a labor cockpit schedule [4:29]
- Schedule 3/8 How to add a team member [2:07]
- Schedule 4/8 How to create a shift code [3:30]
- Schedule 5/8 How to add shift codes to team members [3:41]
- Schedule 6/8 How to create a rotating schedule [3:20]
- Schedule 7/8 How to replace shift codes for a period [2:00]
- Schedule 8/8 How to create split shifts between departments [2:42]
- Stewarding Labor cockpit [11:38]
- Timesheet Onboarding [4:14]
- Show all articles ( 25 ) Collapse Articles
-
- Articles coming soon
-
- Administration Labor cockpit [14:49]
- Bar and Pub Labor cockpit [12:21]
- Breakfast Labor cockpit [12:05]
- Food cost cockpit [6:21]
- Front office Labor cockpit [12:05]
- Housekeeping Labor cockpit [11:20]
- Kitchen Labor cockpit [11:28]
- Labor Cockpit Onboarding [18:16]
- Labor cockpit overview [3:12]
- Repair and Maintenance Labor cockpit [13:01]
- Restaurant Labor cockpit [12:30]
- Schedule 1/8 Navigation [5:12]
- Schedule 2/8 How to create a labor cockpit schedule [4:29]
- Schedule 3/8 How to add a team member [2:07]
- Schedule 4/8 How to create a shift code [3:30]
- Schedule 5/8 How to add shift codes to team members [3:41]
- Schedule 6/8 How to create a rotating schedule [3:20]
- Schedule 7/8 How to replace shift codes for a period [2:00]
- Schedule 8/8 How to create split shifts between departments [2:42]
- Stewarding Labor cockpit [11:38]
- Timesheet Onboarding [4:14]
- Show all articles ( 6 ) Collapse Articles
-
- How to edit a plan [3:52]
- P&L Planning 1/10 Purpose and benefits [2:25]
- P&L Planning 10/10 How to approve forecast and budget or target [2:34]
- P&L Planning 2/10 Navigation [4:26]
- P&L Planning 3/10 How to build a total [4:29]
- P&L Planning 4/10 Three ways of inserting figures [4:32]
- P&L Planning 5/10 How to add a sub account [1:42]
- P&L Planning 6/10 How to build a constant [2:42]
- P&L Planning 7/10 Staff module [2:48]
- P&L Planning 8/10 How to add a staff member [1:33]
- P&L Planning 9/10 How to revise and submit a forecast [3:01]
-
- Articles coming soon
-
-
Onboarding
-
- Onboarding roles overview
- Onboarding roles – Breakfast
- Onboarding roles – Finance
- Onboarding roles – Food cost
- Onboarding roles – Front Office
- Onboarding roles – Housekeeping
- Onboarding roles – Kitchen
- Onboarding roles – Restaurant and Meeting & Event
- Onboarding roles – Stewarding
- Onboarding roles – Repair and Maintenance
- GM Introduction to PMI
- Onboarding roles – Bar and Pub
- Onboarding roles – Administration
-
-
GM's corner
-
PMI homepage
-
PMI planning
-
- How to work with Rooms Budget and forecast
- How to work with non-rooms Budget and forecast
- Use Forecast/Budget hours from Cockpit in P&L Staff module
- How to input a budget in PMI
- Setting productivity targets in PMI
- Express planner overview
- How to run Express planner
- How to configure Express planner settings
- Express planner calculation explanation with examples
- Compiling revenue streams overview
- How to manually enter a revenue budget in PMI
- How to enter a revenue budget in PMI using Live forecast data
- How to enter a revenue budget in PMI using the Data Upload Centre
- How to set monthly labor productivity and hour targets in PMI
- Arrivals, departures, and stay over visibility
- P&L planning automation - how the system calculates your planning schedule
- Plan version automation - Never miss budget season again
- How to set up automated planning cycles
- Show all articles ( 3 ) Collapse Articles
-
- Room revenue Planning: Calculations explanation
- Labor planning: How to edit
- Overview of GoGreen Planning
- How to set up GoGreen planning for a chain or property
- Navigation and filters in NextGen planning page: explanation with examples
- Sense check mode in new planning pages explained
- How to edit a GoGreen plan
-
- Accounts overview
- How to populate and edit accounts
- How to approve a forecast or budget in PMI
- How to copy from reference
- How to edit and update using the staffing tool
- How to make a profit forecast
- How to set up a weekly Live forecast
- How to add a comparison year in P&L
- How to modify a P&L report
- Planning Menu – Tools and View Options overview
- Planning staff module overview
- How to build a P&L planning report
- How to add staff and manage staff cost
- Staffing screen overview
- How to input a budget in PMI
- PMI Planning module overview
- How to add a Food & beverage revenue forecast in P&L Planning
- How to add room revenue in Planning
- Constants explained: how they work in PMI Planning
- Auto-populate P&L Staff hours and rates from Budget & forecast
- Profit & Loss staff – Copy hours and rates to cockpit
- Show all articles ( 6 ) Collapse Articles
-
-
Cockpit
-
- Labor cockpit overview
- Labor Cockpit Preparations
- Labor cockpit cost driver
- SMART forecast explained
- How does SMART allocate daily hours?
- Using arrivals and departures as a cost driver
- Closing Profit Center or Cockpit
- How to work with labor cost
- Min/Max explanation
- Parent and sub-cockpits explained
- Staffing guide explained
- Daily and weekly routines for department heads
- Understanding the importance of including outsourced labor hours in PMI
- How to add labor cost in PMI
- Cockpit rates - Daily weighted payroll projection
-
- Labor cockpit schedule
- How to make a schedule
- How to revise a schedule
- PMI Schedule: Information and Calculation rows explained
- Predefined shift codes
- How to print a schedule
- Revise staff
- Schedule 1/8 Navigation [5:12]
- Schedule 2/8 How to create a labor cockpit schedule [4:29]
- Schedule 3/8 How to add a team member [2:07]
- Schedule 4/8 How to create a shift code [3:30]
- Schedule 5/8 How to add shift codes to team members [3:41]
- Schedule 6/8 How to create a rotating schedule [3:20]
- Schedule 7/8 How to replace shift codes for a period [2:00]
- Schedule 8/8 How to create split shifts between departments [2:42]
- How to work with the Schedule in PMI
- Split Shifts Between Departments
- The Schedule Tools & View menu options overview
- Show all articles ( 3 ) Collapse Articles
-
-
Live forecast
- Live forecast overview
- How to set up a Live forecast: configuration settings
- Live forecast tools and personal view settings
- PMI prediction explained
- Pickup explanation
- Revenue driver explained
- Segment OTB
- Submit Live Forecast to Forecast (monthly routine)
- NextGen Rooms Live forecast overview
- NextGen Rooms Live forecast: Weekly routine overview
- Rooms live forecast: How to work with auto Live forecast
- NextGen Rooms live forecast: Personal view options
- Rooms Live forecast: Sense check mode explained
- How pickup fields are displayed and used in Room live forecast
- Collaborative Forecasting with PMI Prediction
- Non-rooms Live forecast using PMI prediction
- Live forecast – Copy to live forecast
- Live forecast – Revise forecast/budget
- Rooms Live forecast - Edit guest nights factor explained
- Live forecast settings - Configure food revenue by segment
- Show all articles ( 5 ) Collapse Articles
-
Data analysis views
-
Administration
-
- Add documents to a property
- Currency settings
- Fact sheets overview
- Group external hotel
- How to use hours transfer [3:34]
- Hours transfer rules
- Operational status
- Period locking overview
- Share group
- Share hotel
- How to complete Classification Fact sheet
- How to use Period locking for R&P in practice
- How to manage GoGreen Period locking
-
- How to view imported data in the Import status
- Import status overview
- How to read the Import status page
- Handling Outstanding Imports (Missing Data) in PMI
- Understanding the Import status settings
- Import status - Understanding advanced Data offset validation for GoGreen and Food Purchase interfaces
- Import status - Understanding statuses
- How to reload an API import
-
-
GoGreen
-
- Introduction to GoGreen planning
- Overview of GoGreen Planning
- GoGreen plan values explained
- GoGreen planning charts explained: using charts to understand my forecast
- How to set up GoGreen planning for a chain or property
- How to do a GoGreen monthly forecast routine
- Navigation and filters in NextGen planning page: explanation with examples
- Data table general explained
- Sense check mode in new planning pages explained
- How to edit a GoGreen plan
- GoGreen home page overview
- GoGreen Doing Cockpit overview
- GoGreen Learning page overview
- GoGreen index overview
- Weather normalization overview
- CO2 factors overview
- GoGreen targets explanation
- GoGreen index: How are the measurements calculated?
- Useful links for sustainability and environmental management best practice
- How to make a manual entry in a GoGreen cockpit
- Weather normalization explained
- GoGreen benchmarking enhancement - 01.23
- GoGreen – Data Integration & Insights (Overview)
- Environmental Sustainability in Hotels – Foundation
- Environmental Dimensions in Hotel Operations (Energy, Water, Waste, Emissions, etc.)
- Environmental Management Systems (EMS) in Hotels
- GoGreen Monitoring, Measurement, and Performance Evaluation in Hotels
- Waste Measurement and Verification in Hotels
- Emergency Preparedness and Environmental Risk Management in Hotels
- Hotel Water Consumption Profile & Key KPIs
- Domestic Hot Water Systems in Hotels (Efficiency & Legionella Control)
- Cooling Towers and Water Efficiency in Hotel HVAC Systems
- Water Metering, Submetering and Leak Detection in Hotels
- Preventive Water Management Tasks for Hotels
- Nordic Swan Ecolabel for Hotels
- How the Nordic Swan Criteria and Scoring Work
- BREEAM Certification for Hotels Explained
- Green Key Certification for Hotels
- Hotel Energy Consumption and Key Performance Indicators
- Hotel Energy Benchmarking (A++–G Classification)
- HVAC Systems and Energy Optimization in Hotels
- Boiler Systems and Heating Efficiency in Hotels
- Building Management Systems (BMS) and Energy Monitoring
- Preventive Energy Management and Engineering Tasks
- GoGreen Sustainability Knowledge Hub
- Advanced Water Optimization in Hotels
- Smart Leak Detection in Hotels
- Smartvatten Leak Alarms for Hotels
- How to Investigate Water Leaks in a Hotel
- Water Balance Modeling and Water Analytics for Hotels
- Smart Irrigation and Cooling Tower Water Optimization in Hotels
- Hotel Water Management and Optimization – Overview
- How to Control Linen Inventory in Hotels
- How to Set Up a Food Waste Management Program in Hotels
- How to Run a Food Waste Audit in Hotels
- Food Waste Troubleshooting and Best Practices for Hotels
- PMI Energy Heatmap – Understanding Energy Consumption Patterns
- How to Control Your Hotel Using Data and Operational Discipline
- PMI GoGreen Cockpit – Managing Sustainability Performance in Hotels
- How to Set Up GoGreen in PMI
- How to Measure and Manage Waste in Hotels
- GSTC Hotel Standard – What It Is and How It Applies to Hotels
- Green Key Certification for Hotels – What It Is and How It Works
- Sustainability Certifications for Hotels – GSTC, Green Key, Nordic Swan, and BREEAM
- GoGreen in PMI – Sustainability and Operational Efficiency in Hotels
- PMI GoGreen Knowledge Hub
- Hotel Energy Benchmark – Energy Analysis Reference
- Hotel Energy Optimization – Understanding Base Load, Peaks, and Energy Performance
- Hotel Energy KPIs Explained: Base Load, Peak Demand, and Key Metrics
- How to Analyze Hotel Energy Consumption Patterns
- How to Identify Energy Savings Opportunities in Hotels
- Green Key Certification in Hotels – Overview and Practical Application
- Green Key Criteria – Mandatory and Optional Tasks (Pre-defined)
- Show all articles ( 48 ) Collapse Articles
-
-
KPIs
-
PMI adoption index
-
General user knowledge
-
Miscellaneous
-
Access system
- Articles coming soon
-
FAQ
-
- How can I see the hours that are imported to PMI?
- How do I enter the rates?
- How do I know if I am scheduling according to activity?
- How does PMI summarize the hours?
- How is productivity calculated?
- What are fixed hours?
- What are productive and non-productive hours?
- What are the rates and how are they calculated?
- What is a cost driver?
- What is min/max hours?
- Why do the planned hours in the Timekeeping System (TKS) not match PMI?
- Why is the total number of hours for the month too low/high?
- What is SMART?
- How F&B departments can set realistic targets when room revenue drops temporarily
- Why is my MTD SMART productivity different from my ME SMART productivity when my cockpit is locked on Productivity?
-
- How do I estimate my Closing Inventory?
- My food cost % is wrong (too high/low). Why is that?
- My turnover days are set to 32. What does that mean?
- What are my routines in the Food cost cockpit?
- What do I enter in the Purchase column?
- What is opening and closing stock?
- What is the recommended number of turnover days?
- What is turnover days and how is it calculated?
- Where do I change my food cost forecast?
- Why is opening and closing stock important?
-
- Can one employee work in two departments?
- How do I add a shift code?
- How do I copy hours into the unspecified row (Timekeeping system excluded)
- How do I create a rotating schedule?
- How do I make a new schedule?
- How do I navigate the tools in the schedule?
- What are timekeeping system (TKS) excluded hours for?
- How do I add a schedule to my cockpit?
- Do workers added in the schedule get carried over to future months?
-
- Do I have to change my budget & forecast manually every month?
- How can I see what the current cost driver is?
- How do I set a productivity goal?
- How does the cost driver effect my hours and productivity?
- Where can I find the upload function?
- Why are my budget and forecast locked?
- What is Room revenue planning?
-
- How do I copy to Live forecast?
- How do I submit my Live forecast to forecast?
- How do I reset the pickup for a full month?
- Why do I have a red triangle to the left of the date?
- What are Pickup statistics?
- What are covers?
- What are the seasons in PMI?
- What do the pickups show and why are they sometimes negative?
- What is a revenue driver?
- What is the difference between Forecast and Live forecast?
- Why does on the books in PMI not match what we have in our PMS?
- How do I calculate ARR and ADR?
-
- Can I edit the figures in the Flash report?
- Different view options in the Flash report
- How am I performing compared to my forecast/budget/last year?
- How can I print the report?
- How can I switch between viewing daily and monthly figures?
- How do I check what segments add to the total daily figure?
- How do I edit my covers?
- Why are my room/guest nights wrong?
- What is the Flash Report
- Why is my revenue wrong?
- How is the month-to-date forecast and budget calculated in the Flash report?
- Why are the numbers in the Flash report different from the Live forecast?
- Where can I see account mapping details?
-
- How do I know if the mapping is correct?
- How do I know where accounts should go in PMI?
- How do I map the categories in the timekeeping system (TKS)?
- I cannot see my department in Timekeeping System (TKS) mapping. How do I see it?
- There is a position missing in the Timekeeping system mapping. How can I fix this?
- What are Categories in PMI Timekeeping system?
- What is Departments in Timekeeping system (TKS) mapping?
- What is mapping accounts?
- What is mapping – timekeeping system?
- Why don’t I see the spoon and fork icon in account mapping?
-
PMI Release notes
-
- GoGreen Task Bank and Cockpit enhancements - 12.24
- Refrigerants and Fuel Tracking for GoGreen cockpits enhancement - 11.24
- KPI targets enhancement - 10.24
- Automatic renewal of constants enhancement - 10.24
- GoGreen manual entry enhancement - 10.24
- CO2 factors enhancement - 09.24
- KPI targets enhancement - 07.24
- NextGen Rooms Live forecast statistics and pickup data enhancement - 07.24
- Date picker enhancement - 07.24
- Update to NextGen Rooms Live forecast - 06.24
- P&L planning accounts enhancement - 06.24
- Weather normalization enhancement - 05.24
- Update to NextGen Rooms Live forecast page: Sense check updates - 05.24
- PMI adoption index enhancement - 05.24
- PMI adoption index enhancements - April 2024
- Consolidation OTB enhancement - April 2024
- Update to NextGen Rooms live forecast page: Personal view options, Mar 2024
- User administration enhancements March 2024
- GM daily digest enhancement March 2024
- PMI Index calculation updates for 2024
- KPI targets enhancement February 2024
- KPI targets enhancement - January 2024
- Show all articles ( 7 ) Collapse Articles
-
- GoGreen benchmarking enhancement - 01.23
- GoGreen index calculation enhancement - 04.23
- PMI adoption index: Help videos for measurements enhancement - 02.23
- Activity log enhancement - 07.23
- Arrivals and departures forecast enhancement - 02.23
- KPI upload tool enhancement - 08.23
- GoGreen Food waste cockpit enhancement - 08.23
- GoGreen Doing cockpit enhancement - 06.23
- Benchmarking: PMI Index value updates based on time period selected - 06.23
- GoGreen cockpit: Highlight months missing data on 12 month graph - 07.23
- KPI targets enhancement - 01.23
- Goal distribution tool enhancement - 09.23
- Live forecast enhancement: Editing ARR values -12.23
- User administration release note - 12.23
- New page view of Rooms live forecast - 12.23
-
- Benchmarking calculation enhancement - 03.22
- Enhancement to add department type in the P&L report - 03.22
- Print all unmapped accounts on chain level - 03.22
- Printing to Excel and PDF enhancement - 03.22
- Introduction to PMI enhancement
- Room Live forecast – Change to pickup fields - 04.22
- Information/calculation rows in PMI schedule - 09.22
- Export to Google Sheets enhancement - 08.22
- PMI Advanced settings – Period locking - 06.22
- GM daily digest enhancements - 09.22
- PMI adoption index: Option to filter and export scores enhancement - 12.22
- Profit center Live forecast: Automatically switch between OTB and revenue driver
- SMART Forecast enhancement - 09.22
-
d2o team only
-
- Articles coming soon
-
- Articles coming soon
-
- Articles coming soon
-
- Articles coming soon
-
